The South African Special Investigating Unit(SIU) has secured a significant victory in the fight against procurement fraud. The Special Tribunal has officially set aside an R85 million tender previously awarded to the ISF Shula Joint Venture for the construction of a concrete barrier wall along the KwaZulu-Natal-Mozambique border.
The project, which was originally commissioned by the KwaZulu-Natal Department of Transport, was intended as an urgent public safety measure to curb cross-border crime, specifically the smuggling of hijacked vehicles. However, the Tribunal's ruling confirms that the project was marred by deceit and failure from its inception.
A trail of fraud and failure

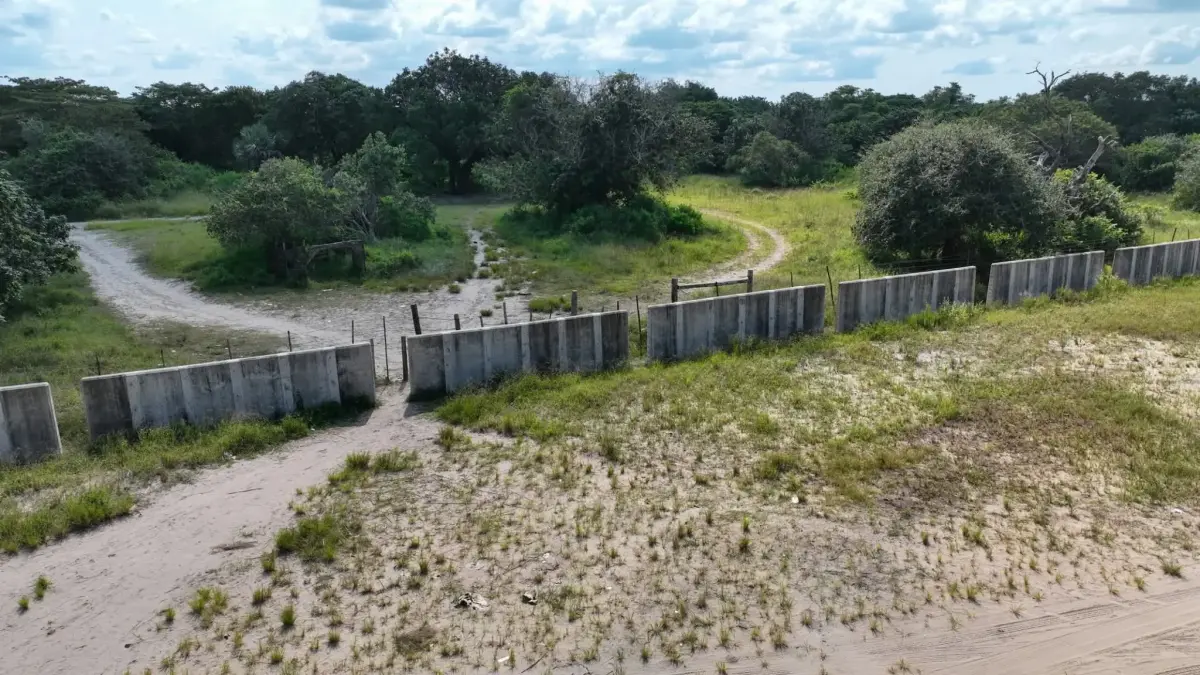

The SIU's investigation exposed a series of red flags and blatant illegalities that led to the project's collapse. Despite receiving R84 million of the R85 million contract, the Joint Venture only completed 5.29 km of the planned 8 km. Furthermore, the investigation found that a fraudulent BBBEE certificate was used to secure the tender.
Beyond the physical failure of the project, the company operated with an expired Letter of Good Standing and failed to meet mandatory financial capacity requirements.
Because the wall was left unfinished, the Department was forced to tender an additional R62 million to a different company to complete the task, placing an extra burden on the taxpayer.
Recovering public funds
The ruling doesn't just stop the contract; it mandates financial restitution. The ISF Shula Joint Venture has been ordered to repay all profits derived from the contract.
To ensure transparency, an independent expert will be appointed by the Joint Venture to determine the exact profit amount. This figure will be reviewed by the SIU, with any disputes being referred back to the Tribunal. Additionally, the Joint Venture has been ordered to cover all associated legal costs.
A message to fraudsters
The SIU was mandated to investigate these allegations under Proclamation R.16 of 2021, which looked into the KwaZulu-Natal Department of Transport's dealings between 2016 and 2021.
The SIU stated that this judgement validates their investigation and sends a clear message that fraudulent certificates, misrepresentation, and incomplete delivery will not be rewarded.
Moving forward, the SIU will refer evidence of criminal conduct to the National Prosecuting Authority (NPA) for potential prosecution. This case serves as a stern reminder of the constitutional imperative that government procurement must remain fair, transparent, and cost-effective.
